[]

(Showing Draft Content)

Create Advanced Layouts

Use a custom SchedulerDefinition when a built-in view does not match the way users need to scan time and resource data. A definition places ordered time and resource bindings on the row and column axes.

Define a custom layout

Binding type

Defines

Typical values

Required properties

Optional properties

Time

Date or time slots

Hour, Day, DayOfWeek, DayOfMonth

type, unit

visible callback

Resource

Groups from scheduler.resources

roomId, teamId

type, fieldExpr

None

Binding order determines which binding becomes the outer group. The fieldExpr of a resource binding must match a configured resource descriptor.

const definition: wjScheduler.SchedulerDefinition = {

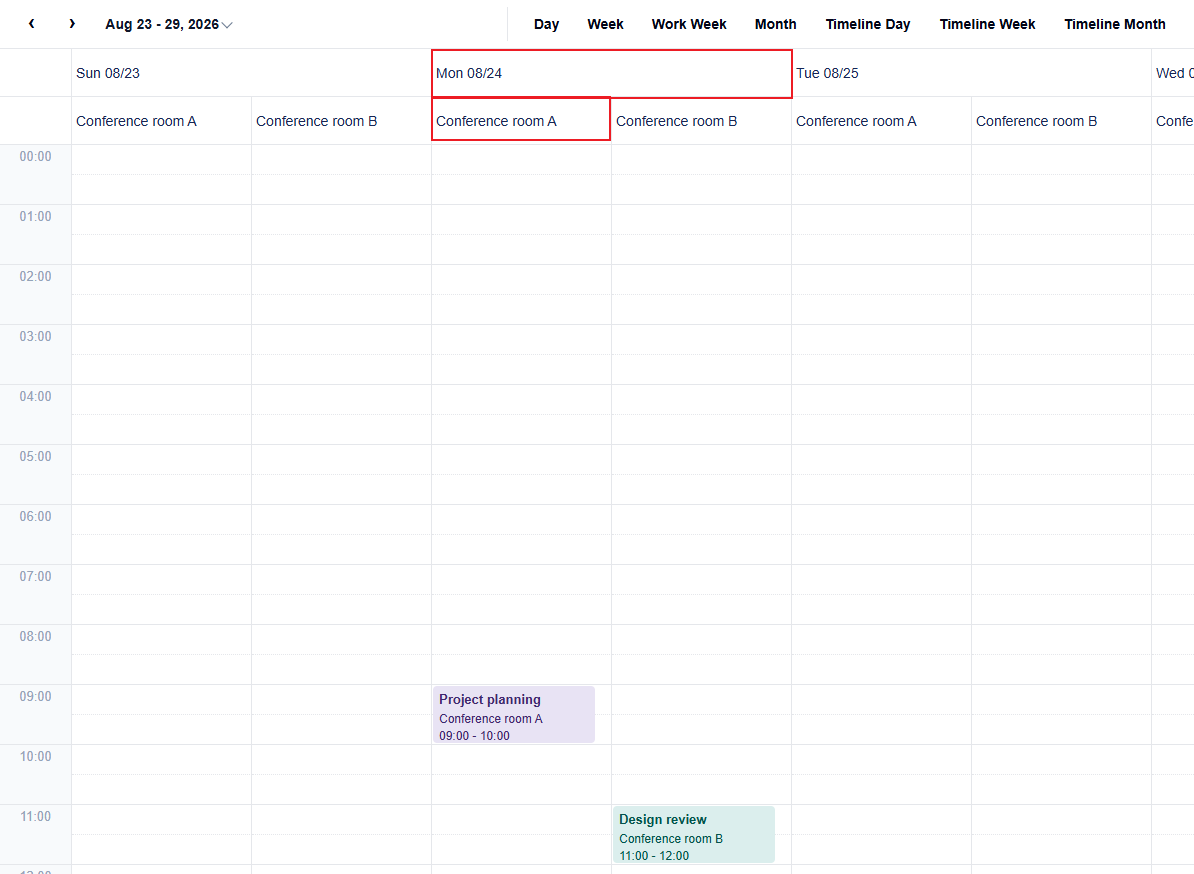

  key: 'weekByRoom',
  rows: {
    bindings: [{
      type: wjScheduler.SchedulerAxisBindingType.Time,
      unit: wjScheduler.SchedulerTimeUnit.Hour,
    }],
  },
  columns: {
    bindings: [
      { type: wjScheduler.SchedulerAxisBindingType.Time, unit: wjScheduler.SchedulerTimeUnit.DayOfWeek },
      { type: wjScheduler.SchedulerAxisBindingType.Resource, fieldExpr: 'roomId' },
    ],
  },
  cellSemantic: wjScheduler.SchedulerCellSemantic.Timed,
};

scheduler.definition = definition;


Check the layout before rendering

Use planSchedulerProjection when views are assembled dynamically or supplied by configuration. It analyzes the definition without changing Scheduler state.

const plan = wjScheduler.planSchedulerProjection(definition);
console.log(plan.slotAxis);
console.log(plan.integrity.level);
console.log(plan.integrity.reasons);

plan.integrity.level reports whether the definition can be rendered as written.

Integrity level

Meaning

Result

faithful

Axis structure and binding order can be preserved.

Renders as configured.

lossy

The view can render, but part of the requested order is normalized.

Renders with normalized grouping.

unsupported

The definition is ambiguous or cannot be projected.

Assigning it throws an error and leaves the previously active definition unchanged.

When Scheduler cannot keep the declared order, it adjusts the layout and reports why in plan.integrity.reasons. The message may say that a binding is normalized or rendered as an outer grouping, which means Scheduler placed it in a group around the time axis.

Timed definition rules

Timed layouts position events by their time range and require one continuous hour axis.

Rule

Valid configuration

Invalid or normalized configuration

Hour axis

Exactly one time:hour binding

Missing or repeated time:hour is unsupported

Hour binding placement

The hour binding is alone on its row or column axis

Sharing the axis with another binding is lossy; Scheduler separates the other bindings into groups instead of preserving the declared mixed order.

Resource identity

Each resource field appears once across both axes

Repeating the same resource field is unsupported

Calendar context

Include a day-level binding when sections need concrete dates

weekOfMonth + hour without a day-level binding is unsupported

In a Timed definition, time:hour must provide one continuous time axis. Keep it as the only binding on its axis and place other bindings on the opposite axis. Use planSchedulerProjection to identify configurations that Scheduler must normalize.

Summary definition rules

Summary layouts arrange fixed-size items inside cells and do not require a time:hour binding.

Rule

Behavior

Repeated time unit

Unsupported when the same unit appears more than once

Repeated resource field

Unsupported when the same resource field appears more than once

Resize

Not supported for summary items

Single lane

A timed definition with one time:hour binding and no bindings on the opposite axis renders one lane for displayDate.

Handle unsupported definitions

Validate a custom definition before assigning it and provide a supported fallback when configuration is user-supplied. Assignment can also be protected with try/catch when definitions are assembled dynamically.

const plan = wjScheduler.planSchedulerProjection(definition);

if (plan.integrity.level === 'unsupported') {
  scheduler.definition = wjScheduler.createSchedulerDefinitionPreset(
    wjScheduler.SchedulerBuiltInViewItem.Week
  );
} else {
  scheduler.definition = definition;
}

Keep definitions minimal while testing a new layout: start with one time binding, add resource bindings one at a time, and verify the resulting grouping before introducing additional axes.
